Realignment of Crestmoor Road at Hillsboro Pike to align with Glen Echo Road. Project also includes a new water main within Hillsboro Pike.
Crestmoor Road Signage and Pavement Markings Plan
Project Funding: 100% Local

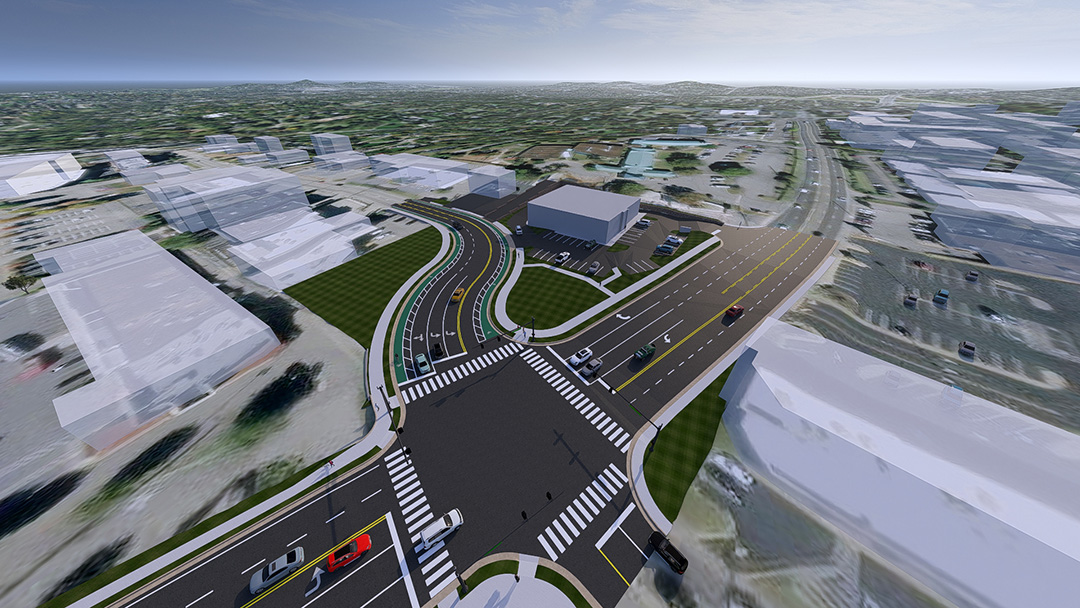

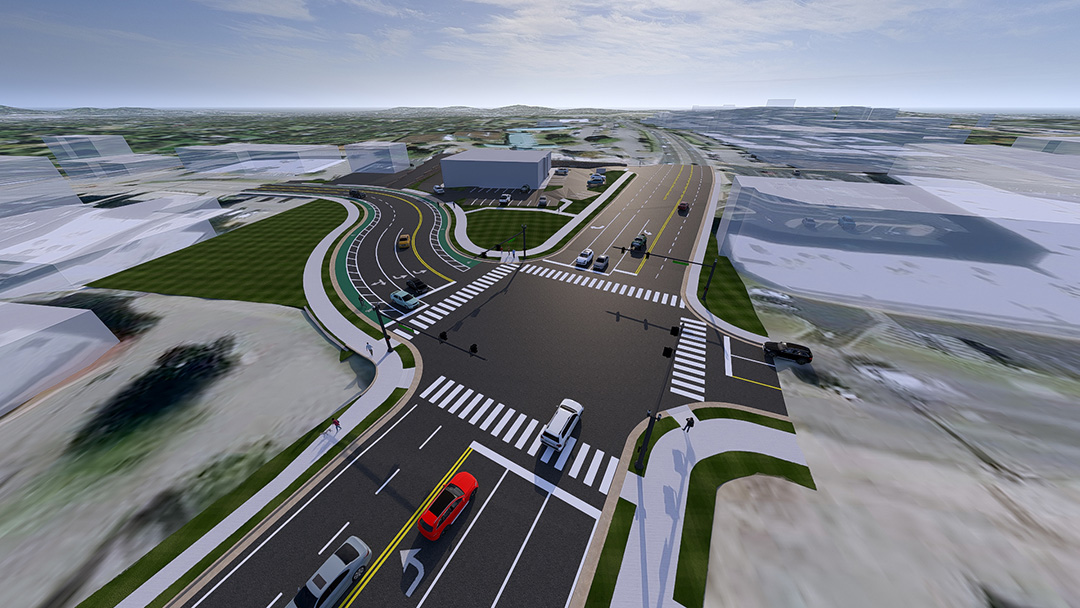

Project Limits
Intersection of Crestmoor Road and Hillsboro Pike
Council District 25: Council Member Jeff Preptit
Project Status
Phase: Construction
Work will resume after the holidays with remaining curb, gutter, and sidewalk installation. After the new year, crews will focus on the remaining concrete work, wall construction, and final paving. All work is weather dependent.
The sidewalk and curb in front of Carrabba’s are already complete, and there will be no traffic impacts on Hillsboro until after the new year. The only work continuing through the holidays will be at the old CVS site, with no impact to Crestmoor or Hillsboro.
The project is currently on track for substantial completion in late March, with only punch‑list items to follow.
Project Timeline
Note: Estimated timeline dates are subject to change based on most current projected schedules from multiple vendors and departments.
Construction Schedule Milestones
- Advertisement for Construction: September 2023
- Contract Award: October 2023
- Contract Fully Executed: November 2023
- Construction Start: January 2024
- Estimated Construction Completion: March 2026
For more information, please contact the NDOT Project Manager at 615-339-1552.
